The electrical path of a mining facility is simpler than a colocation data centre because it is designed for uptime at the lowest cost, not for 99.999% availability. A typical path runs from the utility interconnect to an owned or utility substation, then through step-down transformers to medium-voltage and low-voltage switchgear, and finally to power distribution feeding the machines.
- Machine load
- Current air-cooled ASICs such as the Antminer S21 draw about 3.5 kW each, so one megawatt feeds roughly 280 machines before losses and cooling.
- Distribution voltage
- ASIC power supplies typically accept roughly 200-277 V, so designs distribute three-phase power and land single or phase-to-phase circuits at the rack; many North American builds use 480 V (or 600 V in Canada) distribution with transformers close to the load.

- Redundancy
- Mining normally runs on a single utility feed with N (not N+1) redundancy, no UPS and no generators. A trip costs hashrate, not customer data.
- Metering and curtailment
- Design in sub-metering per hall and fast, controllable load shedding. Demand-response and curtailment programs (ERCOT, MDU's demand-response tariff) pay for flexibility only if you can prove and automate it.
Backup generator cost. Mining sites usually skip generators, but AI-ready or hybrid designs need them. NREL puts installed diesel standby generation at roughly US$1,000 per kW, or about US$1 million per MW (Latitude Media), while 2026 equipment-only pricing runs from about US$125 to US$800 per kW, with the largest industrial units at the low end (Power Generation Enterprises). Redundant (N+1) designs buy more generator capacity than the IT load, and lead times have stretched as data center demand has grown.
Two electrical decisions carry the most long-term value. First, size transformers and switchgear for the load you will eventually have, not just phase one. Second, leave physical space and a path for a second utility feed. Both are cheap on paper at design time and extremely expensive to retrofit, and both matter enormously if the site ever converts to AI hosting.
Mining Data Center Electrical Design: 10 MW Example
Here is how the electrical design of a 10 MW air-cooled mining data center typically sizes out, from the utility down to each miner. Use it to sanity-check a quote or a single-line diagram; it is illustrative, not a stamped design.
| Design element | Typical 10 MW sizing |
| Miner load | About 2,850 S21-class ASICs at 3.5 kW each |
| Utility service | Medium voltage, commonly 34.5 kV (US) or 25 kV (Canada); larger campuses take 69-138 kV into an owned substation |
| Step-down transformers | About five 2.5 MVA pad-mount units (roughly 1.25 MVA per MW so each runs near 80% load) |
| Low-voltage distribution | 415Y/240 V (240 V phase-to-neutral feeds the ASIC directly) or 480 V with step-down near the racks |
| Main switchboards | One roughly 3,000 A switchboard per 2.5 MVA transformer at 480 V |
| Branch circuits | One 20 A circuit per miner (about 15 A at 240 V, sized at 125% for continuous load), balanced across phases |
| Metering and controls | Revenue metering at the service, sub-metering per hall or container, automated curtailment |
| Studies and drawings | Load and short-circuit study, arc-flash study, grounding plan, single-line diagram for the utility |

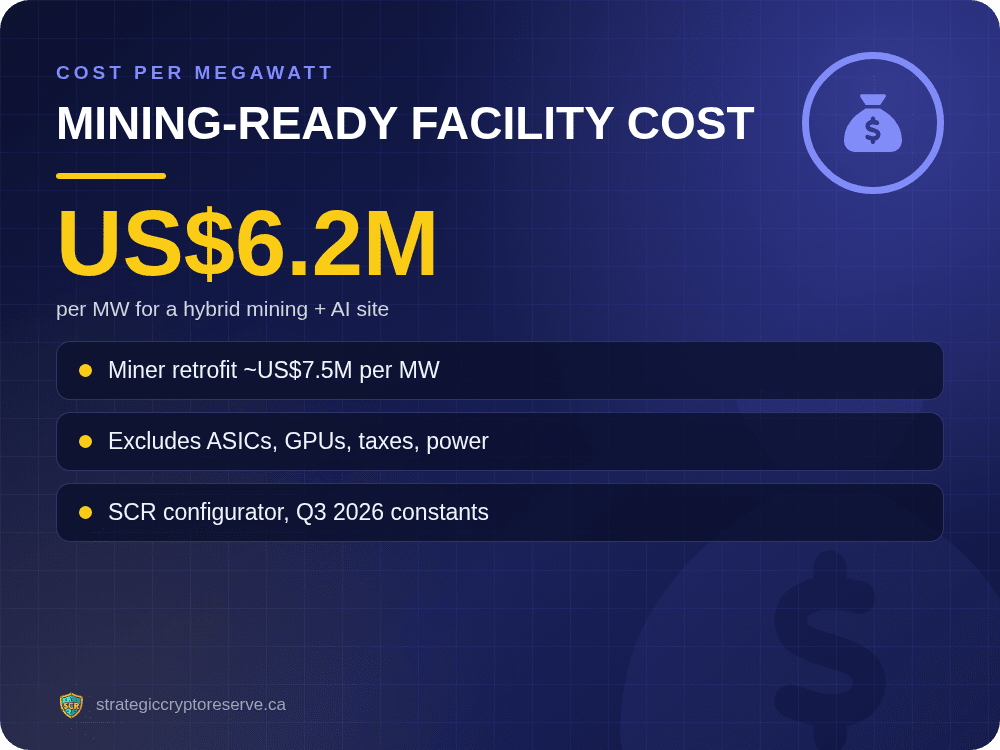

Price this electrical scope, the substation and the rest of the build for your state or province in the AI Build Configurator.
Mining Data Center MEP Design Checklist
MEP (mechanical, electrical and plumbing) design is where a mining site is won or lost. A typical scope:
- Electrical
- Utility service and substation, medium-voltage switchgear, step-down transformers near the load, 480 V (US) or 600 V (Canada) distribution, breakers and PDUs per row, sub-metering, grounding and bonding, and an arc-flash study.
- Mechanical

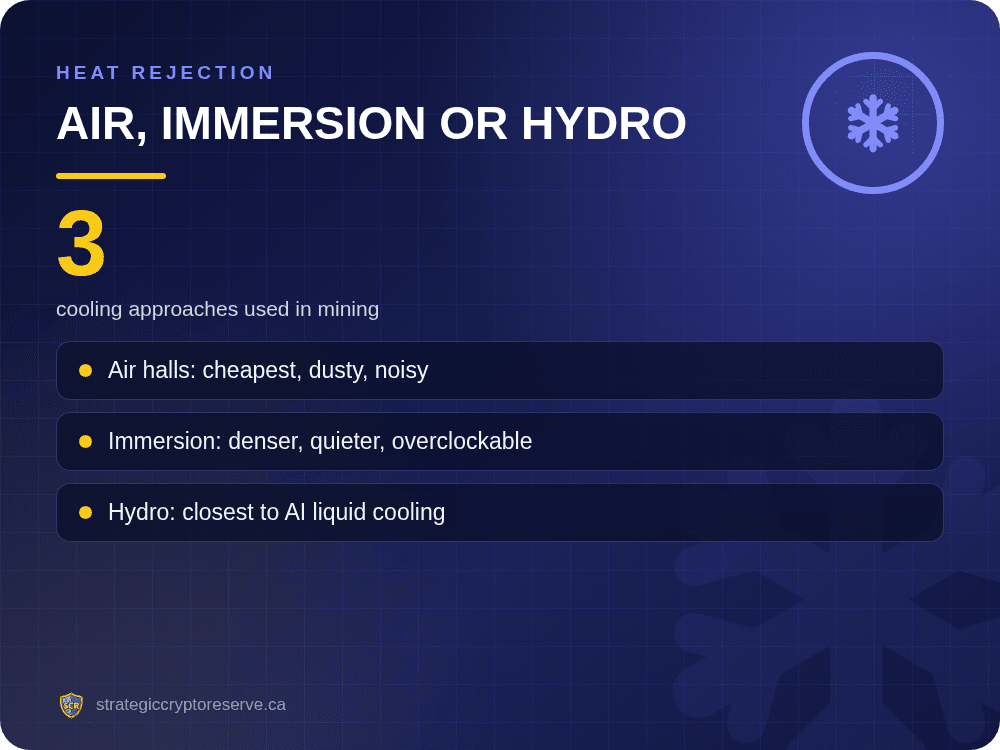

- Air-cooled halls: intake filters, exhaust fans, evaporative pads and hot-aisle containment. Immersion or hydro: pumps, heat exchangers, dry coolers and a coolant distribution loop.
- Plumbing
- Make-up water for evaporative cooling, glycol or coolant loops for immersion and hydro machines, drainage and spill containment, and fire protection.
- Controls
- Building management and monitoring, temperature-driven fan control, and automated curtailment so the site can earn demand-response payments.
- AI-ready allowances
- Space for UPS and generators, a second utility feed, liquid-cooling pipe routes and heavier floor loading, so a later AI conversion does not mean rebuilding.
Mining Data Center MEP Deliverables
A typical MEP package includes a single-line electrical diagram, load and short-circuit calculations, an arc-flash study, grounding and bonding plans, panel and PDU schedules, mechanical airflow or coolant loop drawings, plumbing and drainage plans, fire protection drawings, a controls and curtailment sequence of operations, and stamped construction drawings for permits. Utilities usually ask for the single-line diagram and load study before they confirm an interconnect.
Every MEP design must be stamped by a licensed engineer for the local code. To price the whole build, MEP included, per megawatt, run it in the AI Build Configurator.
