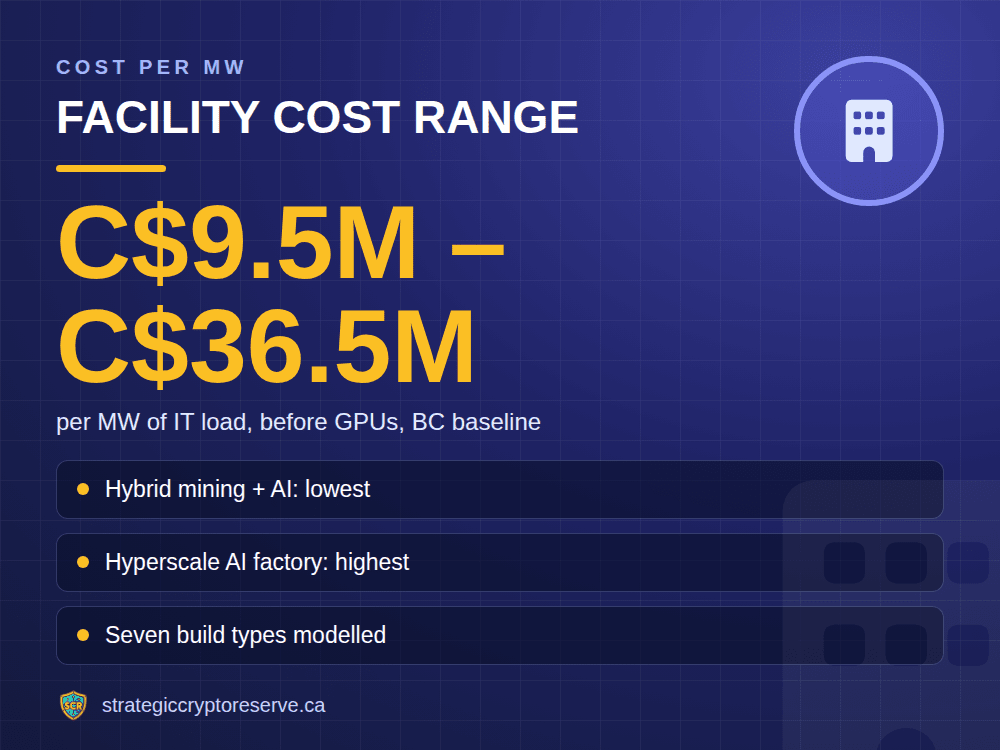

Data center cost splits cleanly in two. Capital cost is everything spent before the first rack goes live: the building shell, mechanical and electrical fit-out, cooling plant, network, land, the utility's connection charges and soft costs such as design and permitting. Operating cost is the yearly bill once it runs, dominated by electricity.

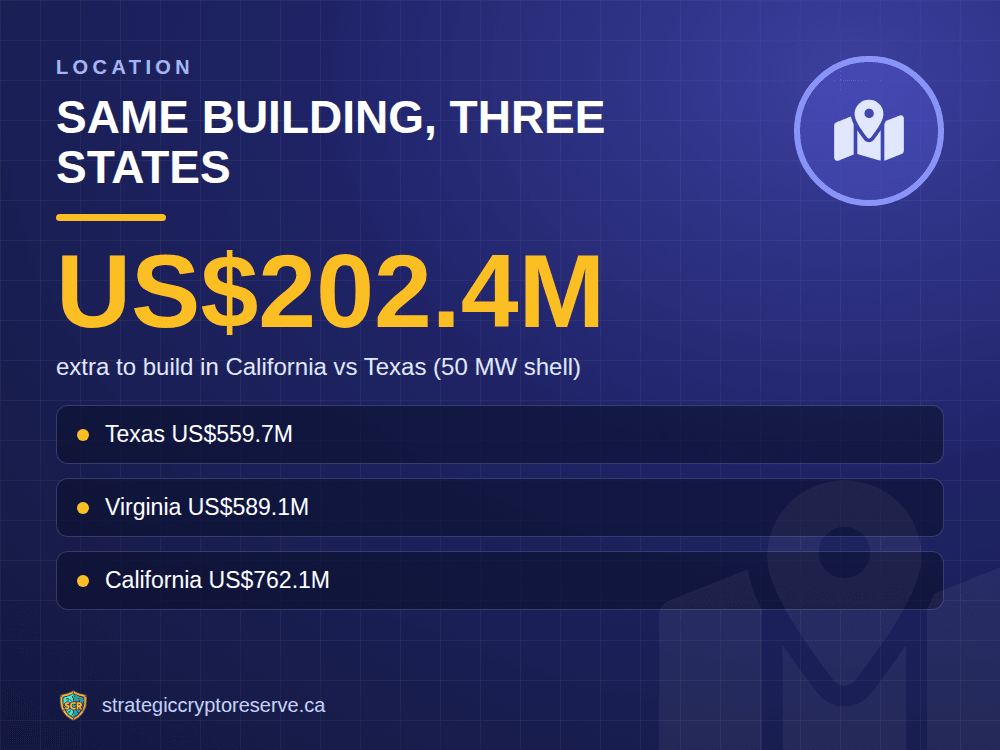

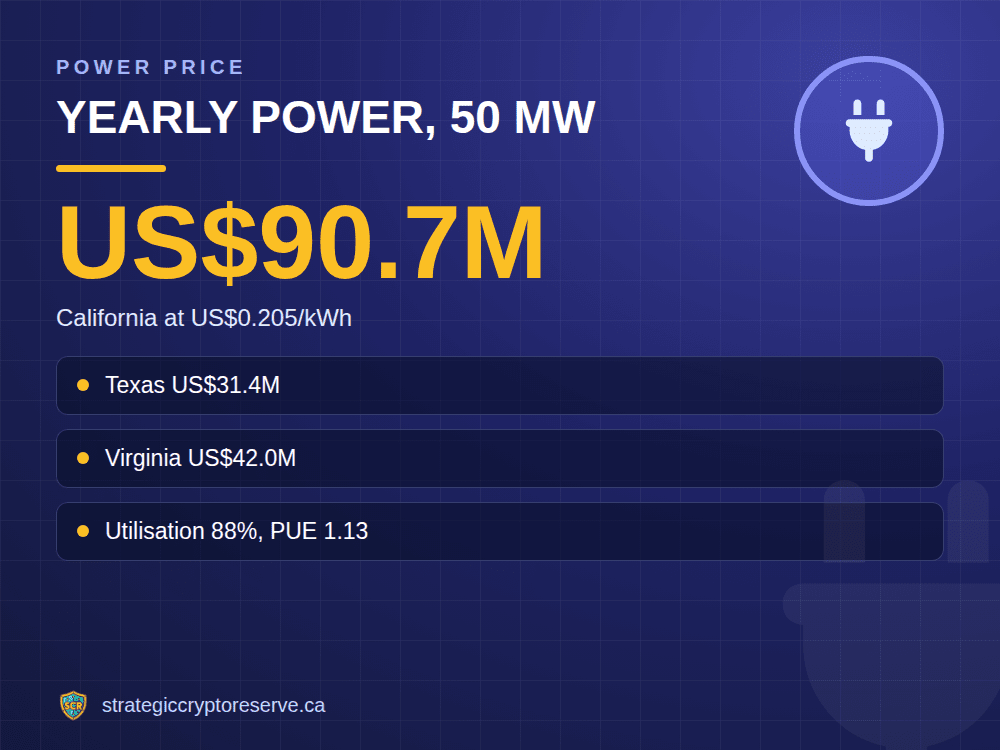

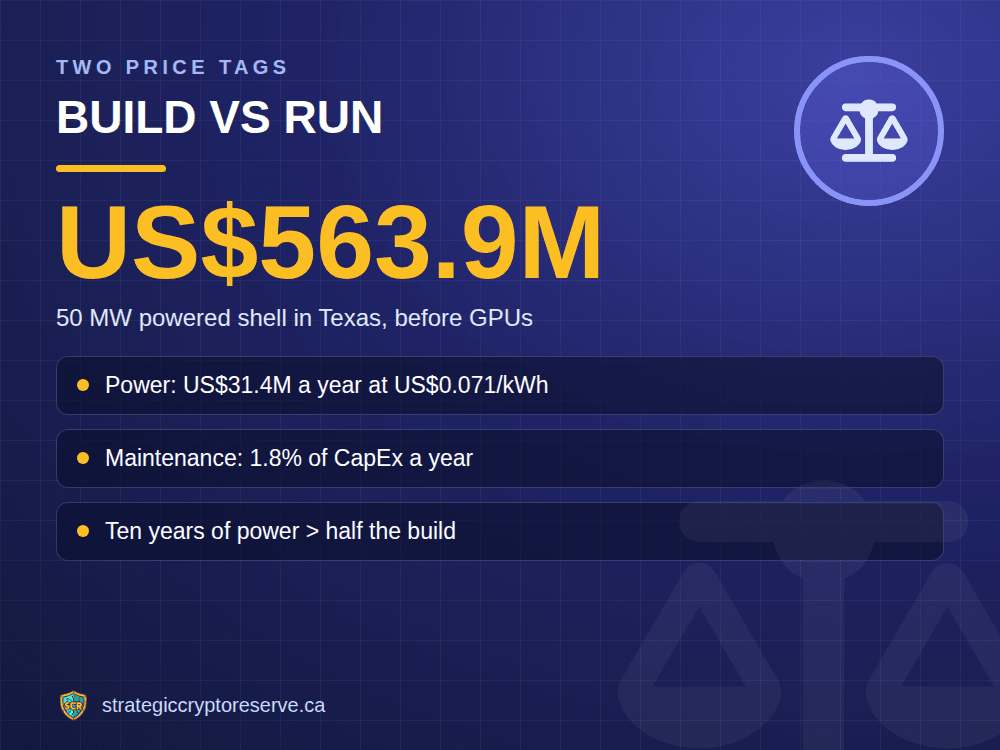

For most facilities the build is the bigger number up front, but power is the line that never stops. A 50 MW site in Texas spends about US$559.7M to build as a powered shell and about US$31.4M a year on electricity at the configurator's modelled ERCOT rate of US$0.071/kWh. Over a ten-year contract, energy alone exceeds half the original build cost.
- Build (CapEx)

- Shell, fit-out, cooling, network, land, utility contribution, 9% soft costs, plus GPUs if you buy them.
- Run (OpEx)

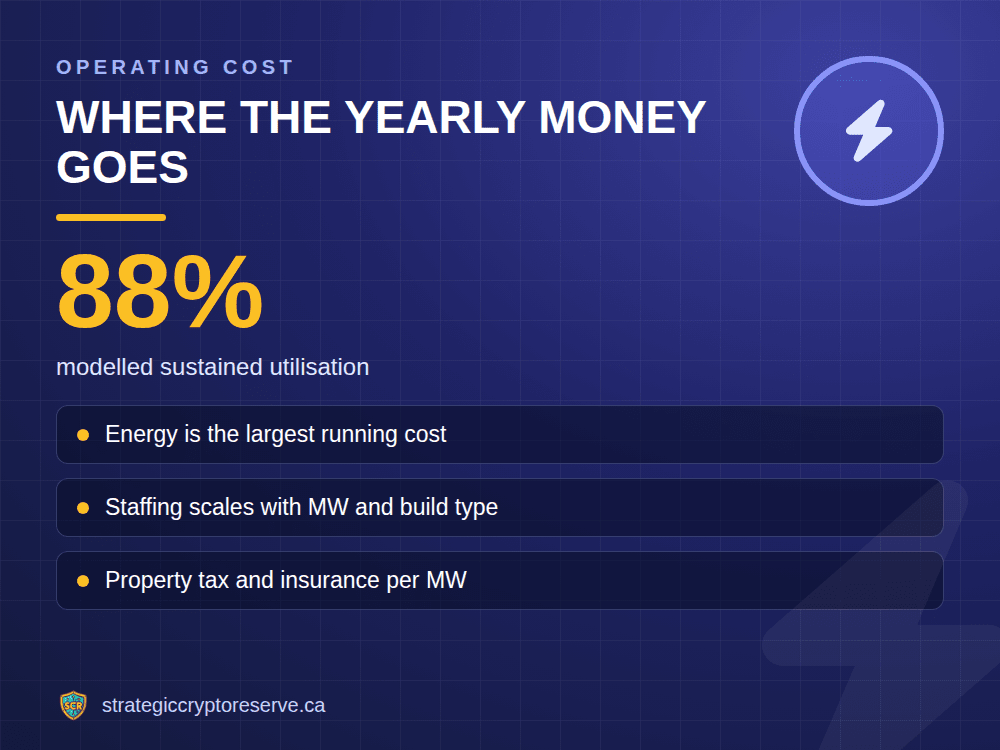

- Energy, maintenance (1.8% to 4% of CapEx a year by build type), staffing, property tax and insurance, G&A.
- The swing factor
- Location: power rate, construction cost factor, sales tax on equipment and the grid queue.
